Scheduling
Schedule orders manually or using AI-powered optimisation.
The core function of the Scheduler is to facilitate optimal operational decision making. The graphical scheduler and optimisation algorithms work together to help planners create feasible schedules.
Navigation
Open a scenario from Scheduler > Scenario, then click Open to enter the scheduling view.
Ensure all configuration is completed — including Equipment, Materials, Personnel, Operations, and Availability — and that you have orders available in the scenario before scheduling.
Scheduling Steps
Select orders from the Orders Store and add them to the scenario (populates the Unscheduled Orders grid).
Run Optimise, or manually schedule via drag and drop.
Refine the schedule using the interactive features of the scheduling board.
Interface Overview
The scheduling view consists of:

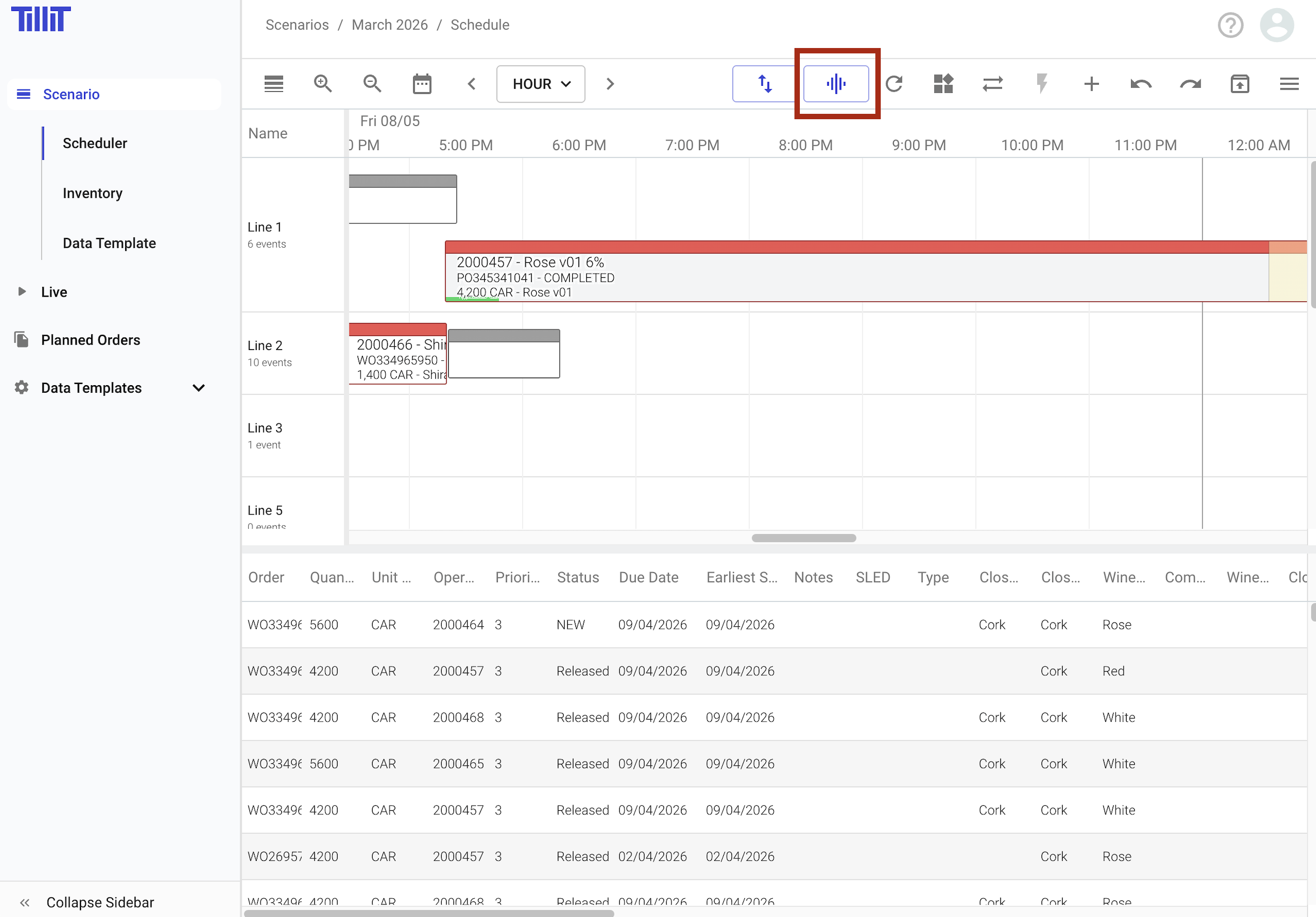

Gantt chart — visual timeline showing equipment rows and scheduled orders
Unscheduled Orders grid — orders added to the scenario but not yet placed on the timeline
Scheduled Orders grid — orders on the timeline with detailed start/end times
Toolbar — optimise, filter, view options, and freeze date controls

Manual Scheduling

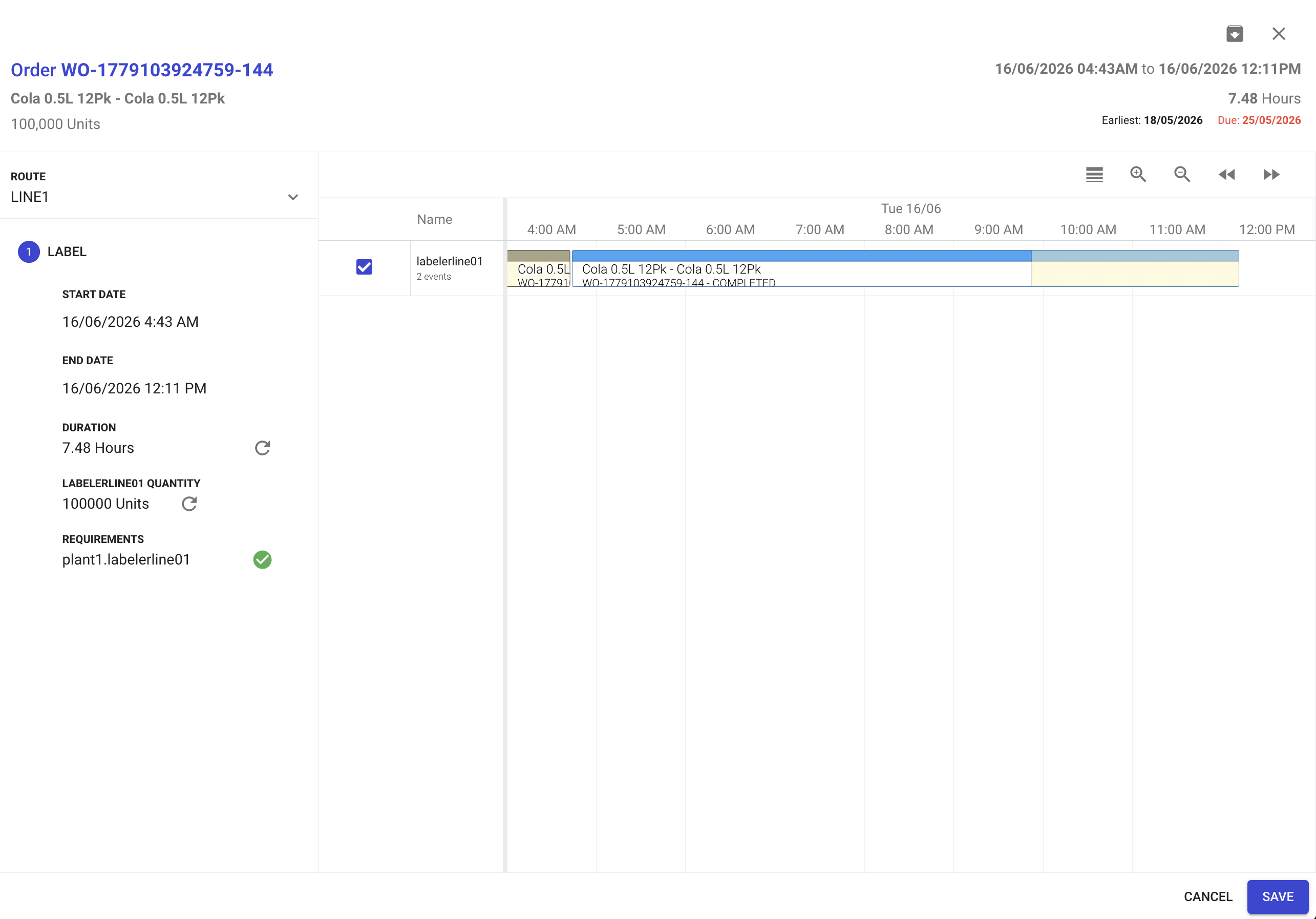

Drag and drop orders from the Unscheduled Orders grid onto the Gantt chart. Only resources compatible with the order's operation are highlighted as valid drop targets.

Scheduler Controls
Drag and drop
Move scheduled orders forward or backward to any time
Resize
Adjust order duration by hovering at the edge and dragging. Zoom in to daily or hourly level first — resize is disabled at long-term zoom levels
Filters
Limit what is displayed in the scheduler and grid (e.g. show only a single machine and its orders)
Unschedule
Remove orders from the schedule and return them to the Unscheduled grid
Left click
View more detail about the order
Double click
Open the Allocations screen
Allocations
Allocation is the process of assigning specific resources when you have multiple route options or a multi-step operation. The Allocations screen shows a detailed view of resource assignment and route selection.

Each step in a multi-step operation has resource requirements that must be fulfilled. The timeline displays all available and compatible resources, along with existing allocations on those resources.
Optimised Scheduling
The AI-powered optimiser automatically creates schedules based on configured Optimisation profiles.
Running the Optimiser
Import the required orders into the scenario.
Ensure the optimisation configuration is complete.

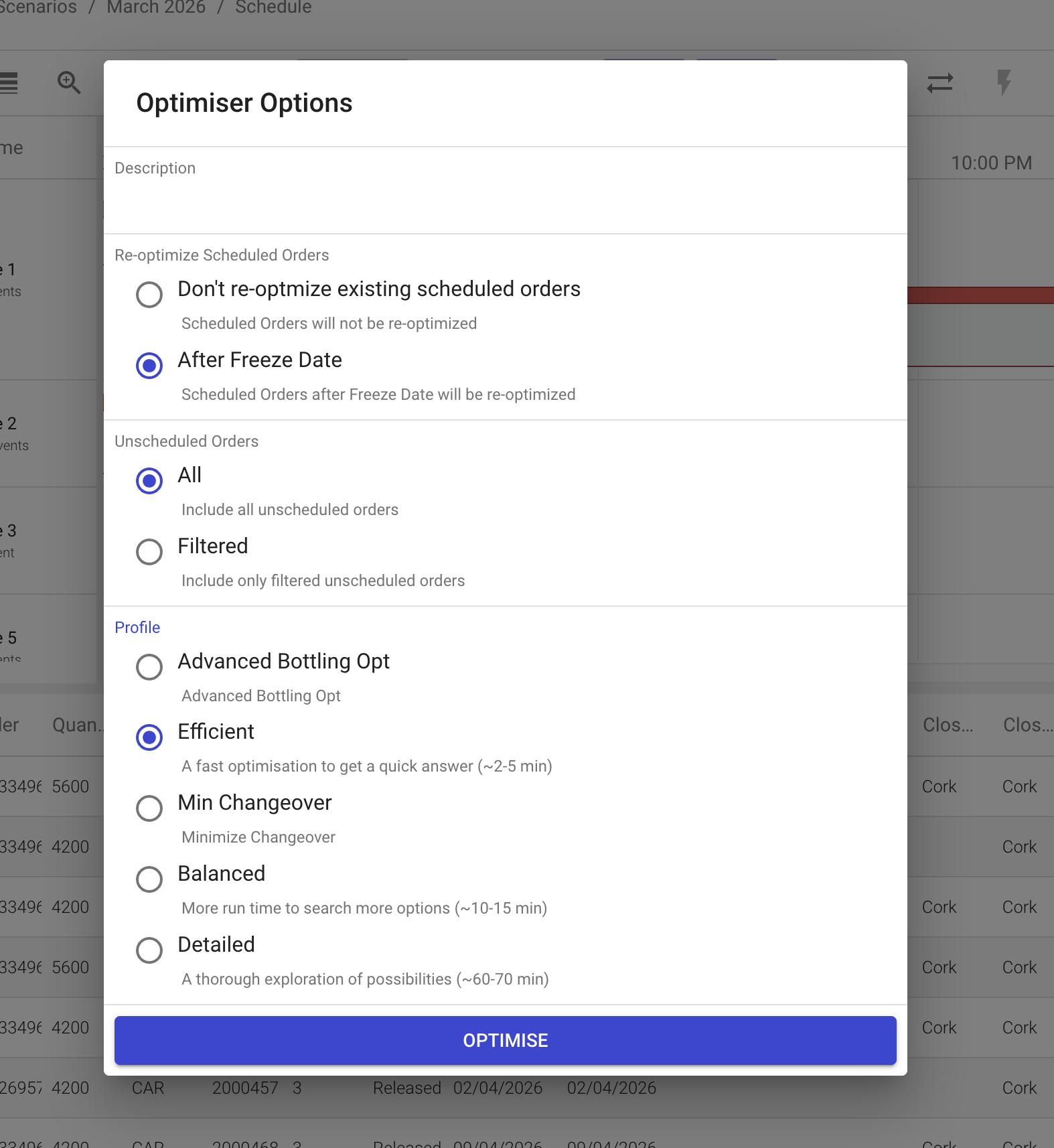

Click the Optimise button in the scheduler toolbar.

4. Choose whether to optimise everything after the freeze date and/or keep existing scheduled orders locked.

5. The optimiser processes all orders — this usually takes between 2 and 10 minutes for large order volumes. 6. Results are displayed once optimisation is complete.
If the Optimise button shows red after processing, check your configuration settings for issues.
Frozen and Locked Orders
When optimising, two modes control which orders are affected:
Optimise after freeze date
All orders after the freeze date are re-optimised, including new unscheduled orders
Keep locked orders
Orders already on the schedule stay in place. The optimiser only allocates unscheduled orders into the remaining gaps
Freeze Dates
The freeze date locks in scheduled activities before a specific point in time.
To set a freeze date, click, hold, and drag the freeze line on the Gantt chart. All orders before the freeze date cannot be changed and will not be rescheduled during optimisation.

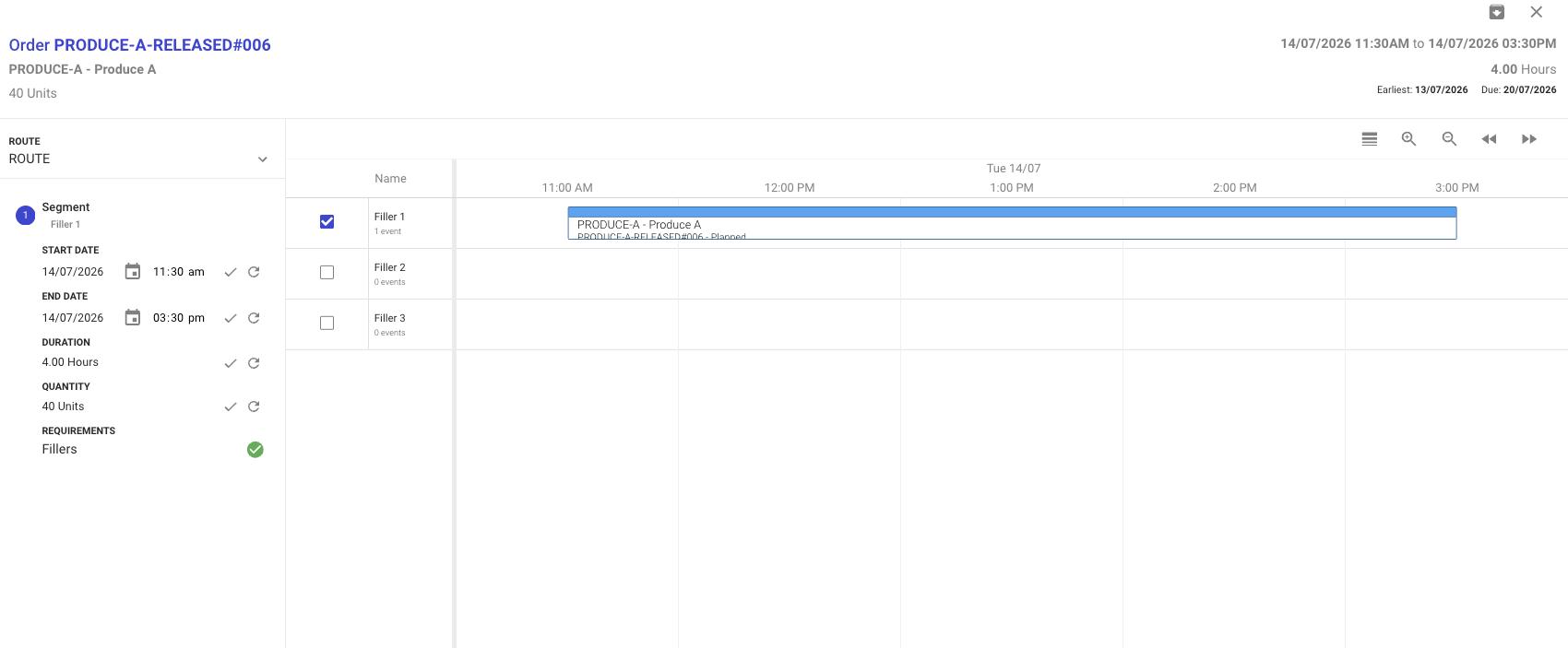

Splitting an Order Across Linked Lines
An order can be split across two linked lines (for example, Line A and Line A1) with a configurable time offset so that the second line starts at a different time rather than simultaneously. The total output across both lines sums to the original order quantity.
How to Split an Order
Click on an order allocation on the Gantt chart.
Click the pen icon to open the order scheduling details.
Tick the checkbox for the additional asset you want to split the order onto.

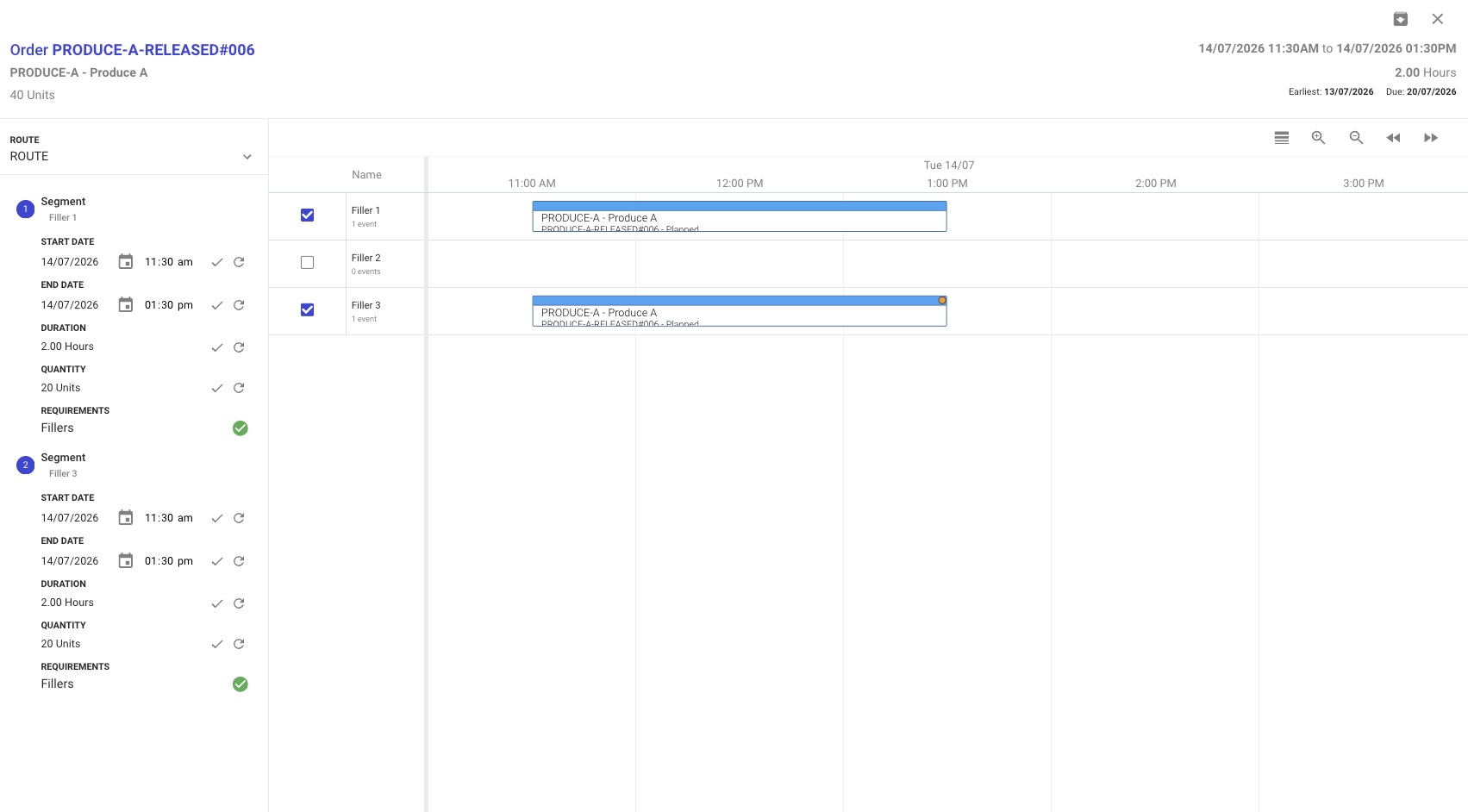

The Scheduler performs a best-effort split so that the combined target production and duration adds up to the original order values.

Dependency Visualisation
When an operation is selected on the Gantt timeline, dependency arrows show the relationships between linked operations.
Arrow styles differ by dependency type:
Solid line
Segment-level and order-level dependencies
Dashed line
Material dependencies
Order Dependency Toggle
The Order Dependency toggle in the Scheduler Settings drawer controls which arrows are displayed:
OFF (default)
Segment and material dependency arrows
ON
Segment and order dependency arrows

Last updated
